Move-out punch list with 12 small repairs and a 3-day deadline: how to scope one work order

A short turnover deadline is met by turning each punch list item into its own priced line on one work order, with a cap and a date. Twelve numbered lines, one cap per line, one approval and a three-day schedule keep every repair visible and every invoice traceable.

A move-out punch list works only when every item has a line, a price and an owner. The commercial property maintenance work order checklist lists the scope, cap and closeout photos to request before the three-day clock starts.

How do you structure one work order for 12 move-out repairs?

One work order for 12 repairs lists each item as a numbered line with location, scope, a not-to-exceed amount and a status. The manager approves the whole sheet once, the vendor works the lines in order, and nothing outside the lines proceeds without a written quote.

Three-day turnover schedule: day one walkthrough and quote, day two repairs, day three closeout photos and one invoice.

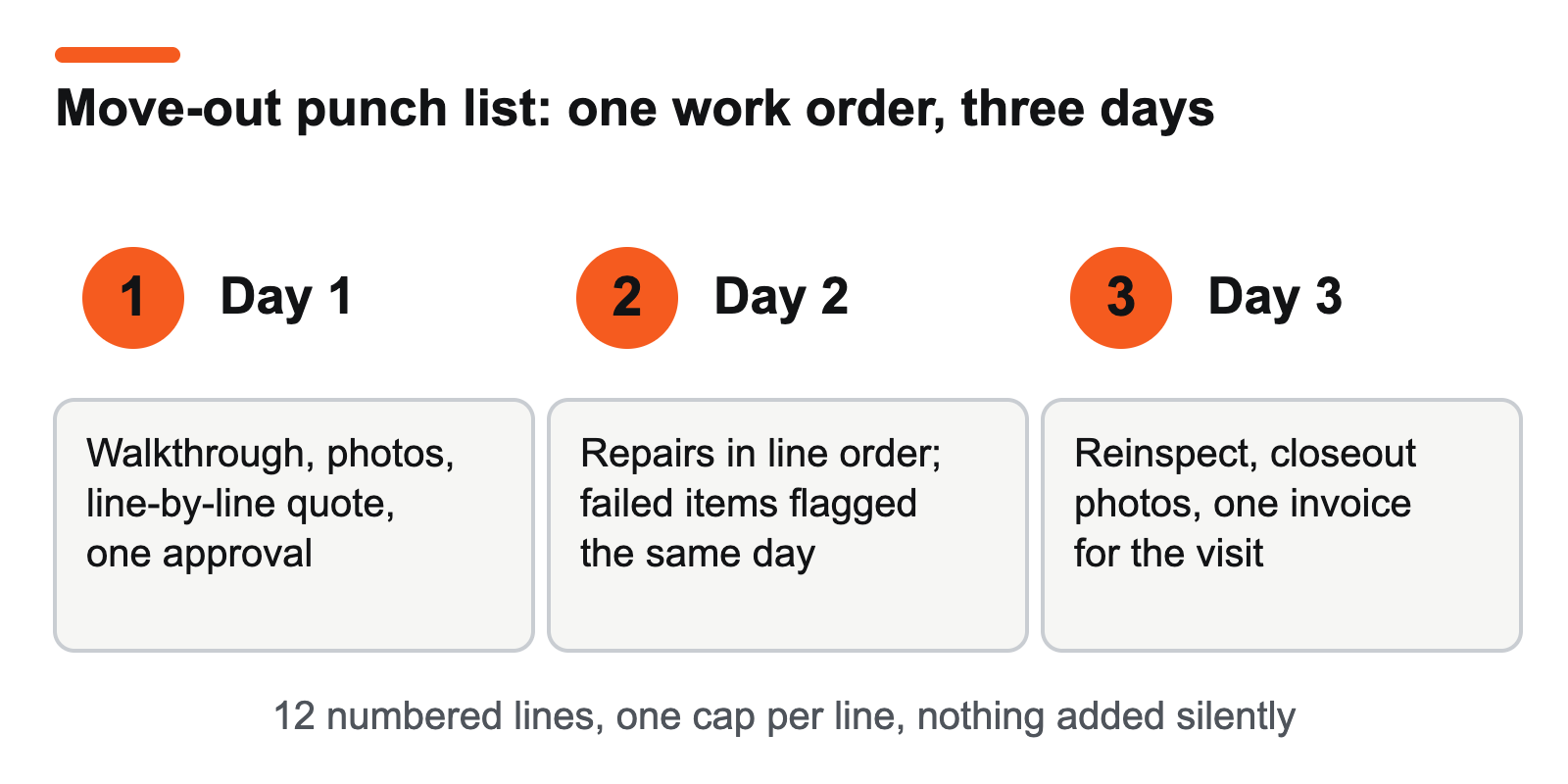

The three-day sequence for twelve move-out repairs.
LineItemLocationScopePublished range
1Patch and paint drywallRear stockroomTwo patches, match the existing sheen$85 to $250
2Replace door closerFront entrySwap and set closing speed$120 to $280
3Re-anchor wall displaySales floor, north wallRe-mount into blocking or a studWritten quote
4Replace stained ceiling tilesBack officeThree tiles, after the leak source is confirmedWritten quote
5Re-secure grab barStaff restroomRe-anchor into backingWritten quote
6Lock serviceRear doorRekey and testWritten quote

This sample shows six of the twelve lines; lines 7 to 12 follow the same format. Set each line cap at the written quote, not at the top of a range.

What does a three-day turnover schedule look like?

A three-day turnover runs in a fixed order: walkthrough and written quote on day one, repairs on day two, and closeout photos with a punch list sign-off on day three. Anything found after the walkthrough becomes a new line with its own cap, not a silent addition.

  1. Day one: walkthrough, photos, line-by-line quote and approval of the whole sheet.
  2. Day two: repairs in line order, with any failed item flagged the same day.
  3. Day three: reinspection, closeout photos and one invoice for the visit.

For account clients we typically confirm urgent scheduling within two to four hours, and invoices run net-30 for approved accounts.

How does our team run a move-out inspection and punch list?

Led by Bernard Toth, our team runs a move-out inspection as one walkthrough with the property manager, building a numbered punch list on the spot. Each line gets a location, a photo, a scope and a not-to-exceed amount before approval, so repairs finish inside the turnover window and the invoice matches the list.

  1. Walk every room in a fixed order with the manager and number each item as you go.
  2. Photograph each item with its location in frame.
  3. Flag anything that will cross $1,000 or needs a permit, so the manager hears about it before work begins.
  4. Send the line-by-line quote and get one approval for the whole sheet.
  5. Work the lines in order, flag any failed item the same day, and finish with closeout photos and one invoice.

A fixed route and a numbered list also make the next move-out faster, because the same items show up in the same order.

Pricing the first line usually starts with the minimum charge; see how to compare minimum charges on a short repair. After handover, a monthly walkthrough report keeps the next turnover list short.

Send the address, the scope and a few photos through the quote and work-order form, or call or text +1 818-835-0556. We serve Southern California and the Bay Area, and dispatch and office hours are Monday through Sunday, 8 AM to 6 PM.

Prices reflect The Handy Geeks published commercial rates reviewed October 2026.
